FRONTIER LITHIUM'S FEASIBILITY STUDY CONFIRMS CA$932M NET PRESENT VALUE AND LOW-COST CONCENTRATE SUPPLY FOR PAK LITHIUM PROJECT
                            Updated Mineral Reserve Estimate Confirms 37% Growth in PAK Project
  newswire.ca  			  				News provided by 				 					 						 							 								  							 						 						Frontier Lithium Inc. 							 								 									 								 							 							 						 						 					 				 				May 28, 2025, 22:17 ET
  GREATER SUDBURY, ON, May 28, 2025 /CNW/ - Frontier Lithium Inc. (TSXV:  FL) (FRA: HL2) (OTCQX: LITOF) (the "Company" or "Frontier") is  pleased to report the results of its Definitive Feasibility Study ("FS"  or "Study" or "DFS") for the Mine and Mill segment of PAK Lithium  Project ("PAK Project" or "Project") near Red Lake, Ontario.  The Study confirms the Project could generate an estimated CA$11  billion in net revenue over a 31-year mine life, with an after-tax net  present value (NPV) of CA$932 million, an Internal Rate of Return (IRR)  of 17.9%, and average annual pre-tax earnings of $285 million  in steady-state operations. These robust economics land the Project  competitively in the global hard rock lithium cost curve, supporting  Frontier's goal to become North America's lowest-cost producer of spodumene concentrate.

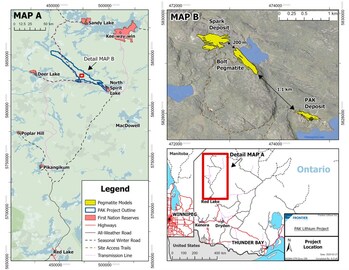

                                                                   Figure 1: Map Showing a Plan View of the Resource Models For  PAK, Spark and Bolt Deposits. (CNW Group/Frontier Lithium Inc.)

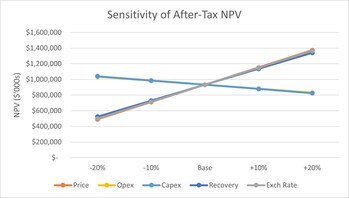

                                                                   Figure 2: Sensitivity of NPV to Capex, Opex, Recovery, Exchange  rate and Concentrate Price (CNW Group/Frontier Lithium Inc.)
                                                                   Figure 3: PAK Lithium Project, Mine and Mill Indicative Timeline (CNW Group/Frontier Lithium Inc.)
  Building on a 37% increase in mineral reserves, the  Study establishes a stronger foundation for an extended mine life,  greater scale, and improved economic outcomes for the Project. The  Project has also been streamlined to produce a single, high-quality  spodumene concentrate (SC6), aligning with market demand and enhancing  operational focus.

              	  "This DFS is a key milestone that builds the confidence  to advance permitting, infrastructure, and strategic partnerships. With  strong projected economics, low costs, and long-term earnings, the  Project could drive self-funded future growth and support Canada's Critical Minerals Strategy," said Trevor Walker, President and CEO. He added, "Canada's  pro-battery policies give Frontier a strategic edge as regional lithium  supply deficits are expected to continue into the 2030s. We're  developing a high-quality, large-scale, low-cost lithium resource to  anchor a domestic supply chain—strengthening energy security,  competitiveness, and sustainability. This is more than a lithium  project—it's about nation-building and delivering long-term value to  shareholders and generations of Canadians, including northern and  Indigenous communities."
              	  Kota Ikenishi, General Manager of Battery Minerals  Department at Mitsubishi Corporation, added: "We're very pleased with  the release of this DFS, which marks an important step forward for the  project just over a year after our investment. This progress reflects  the strong commitment and capability of Frontier, and we truly  appreciate their continued efforts. The DFS results highlight the  project's outstanding quality and scale, showing that it stands among  the top-tier lithium projects in North America. We believe that the PAK Project will make a meaningful contribution to building a reliable battery supply chain in Ontario, Canada and across North America. We look forward to continue working closely with our partner as the project moves toward production."
  Highlights of the Feasibility Study
  Strong Project Economics (All in Canadian Dollars unless otherwise stated)
  The DFS  outlines a phased development plan, consisting of with a mine and mill  to produce 6% Li2O spodumene concentrate (SC6). The Project delivers  compelling economics, including:

 - Potential cumulative net revenue: CA$11 billion
 - After-tax Net Present Value (NPV8%): CA$932 million
 - After-tax Internal Rate of Return (IRR): 17.9%
 - Average annual earnings (steady state): CA$285 million
 - Life of Mine (LOM): 31 years
  These results provide a robust basis for the Company to advance a  Final Investment Decision (FID) target within the next 24 months.
  Industry-Leading Cost Profile

 - C1 Operating Cost1,2 (including transport): CA$602/t SC6 (US$439/t)[2]
 - All-in Sustaining Cost (AISC)3,4: CA$624/t SC6 (US$456/t)
 - Average Annual SC6 Production: 200,000 tonnes
 - Life-of-Mine Stripping Ratio: 3.7:1 (waste:ore)
  Concentrate transportation assumptions are based on free on board (FOB) terms at Thunder Bay, where Frontier recently acquired a vacant industrial site on Mission Island to house its planned lithium conversion facility5.  These cost metrics position the PAK Project firmly in a competitive  position on the global hard rock cost curve, underscoring its strong  cost competitiveness and resilience in volatile market conditions.
  Substantial Economic Contribution

 - Over $1 billion in federal and $699 million in provincial tax revenues expected over the life of the Project.
 - Additional $645 million of Ontario Mining Tax estimated for the province;
 - Creation of more than 230 jobs at the mine site and sustained for the life of the Project.

                                     _________________________________
    |                        1C1  Cost and C1 Cost per tonne of concentrate sold: C1 Cost consists of all  production related expenses including mining, processing, services,  tailings handling, royalties, and general and administrative, plus  treatment charges, penalties, transportation and other selling costs. C1  Cost per tonne of concentrate sold is calculated as C1 Cost divided by  tonnes of spodumene concentrate sold.
    |                        2 US$:CA$: 1.00:1.37
    |                        3  All-in Sustaining Costs (AISC) and AISC per tonne of concentrate sold:  AISC consists of C1 Cost plus sustaining capital. AISC per tonne of  concentrate sold is calculated as AISC divided by tonnes of spodumene  concentrate sold.
    |                        4  C1 Costs and AISC are non-GAAP financial measures or ratios and have no  standardised meaning under IFRS Accounting Standards and may not be  comparable to similar measures used by other issuers. As the Project is  not in production, Frontier does not have historical non-GAAP financial  measures nor historical comparable measures under IFRS, and therefore  the foregoing prospective non-GAAP financial measures or ratios may not  be reconciled to the nearest comparable measures under IFRS
    |                        5  The lithium conversion facility will be developed separately by  Frontier and is not included in the cost metrics described herein nor in  the associated Technical Report.
    |                                 Expanded Mineral Reserves, Resources and Exploration Upside

 - Proven & Probable Reserves: 31.1 million tonnes @ 1.51% Li2O — a  37% increase over the Company's pre-feasibility study published in  2023.
 - Maiden Inferred Resource at the Bolt deposit: 5.5 million tonnes @ 1.23% Li2O.
  All deposits remain open at depth and with the recent Ember  pegmatite discovery, located 1 km north of the Spark deposit, this  further highlights the ongoing exploration upside and broader regional  potential.
  Frontier is advancing project financing and has  commenced the permitting process which is expected to be completed  within the next two years.
  Table 1. PAK Project DFS – Summary of Key Results and Assumptions
                                     Description
    |         Units
    |         Value
    |                        Macroeconomic Parameters
    |                        SC6 Spodumene Concentrate Price, Long-Term
    |         US$
    |         1,475
    |                        US$:CA$ Exchange Rate, Long-Term
    |         US$:CA$
    |         1.00:1.37
    |                        Inflation Rate, Long-term1
    |         %
    |         2.0
    |                        Project Parameters
    |                        Discount rate (real terms)
    |         %
    |         8.0
    |                        Mine life
    |         Years
    |         31
    |                        Mineable Mineral Reserves, Total
    |         Mt of ore
    |         31.1
    |                        Mineable Mineral Reserves, PAK
    |         Mt of ore
    |         3.9
    |                        Mineable Mineral Reserves, Spark
    |         Mt of ore
    |         27.2
    |                        Grade Mined, PAK (LOM average)
    |         % Li2O
    |         1.96
    |                        Grade Mined, Spark (LOM average)
    |         % Li2O
    |         1.44
    |                        Annual Mill Throughput (LOM average)
    |         Ktpa
    |         1,040
    |                        Lithium Recovery, PAK (LOM average)
    |         %
    |         77.9
    |                        Lithium Recovery, Spark (LOM average)
    |         %
    |         77.5
    |                        Concentrate Grade
    |         % Li2O
    |         6.0
    |                        Total Concentrate Produced (LOM)
    |         Mt
    |         6.1
    |                        Capital Expenditures (real terms)
    |                        Development Capital
    |         CA$ M
    |         943
    |                        Sustaining Capital
    |         CA$ M
    |         137
    |                        Closure Capital
    |         CA$ M
    |         60
    |                        LOM Unit Operating Expenditure (real terms)
    |                        Mining
    |         CA$/tonne of ore processed
    |         28.7
    |                        Processing
    |         CA$/tonne of ore processed
    |         31.3
    |                        Tailings Management Facility
    |         CA$/tonne of ore processed
    |         1.2
    |                        Non-process power
    |         CA$/tonne of ore processed
    |         1.2
    |                        Heating
    |         CA$/tonne of ore processed
    |         0.9
    |                        G&A5
    |         CA$/tonne of ore processed
    |         23.7
    |                        Total Opex
    |         CA$/tonne of ore processed
    |         87.0
    |                        Other Expenditures (real terms)
    |                        Concentrate transport costs
    |         CA$/tonne of concentrate sold (wet)
    |         143
    |                        LOM Undiscounted Cash Flows (real terms)
    |                        Net Revenue
    |         CA$ M
    |         11,298
    |                        Total Opex
    |         CA$ M
    |         (2,709)
    |                        Closure Bond Fees
    |         CA$ M
    |         (19)
    |                        Operating Earnings
    |         CA$ M
    |         8,569
    |                        Capital Expenditures
    |         CA$ M
    |         (1,138)
    |                        Clean Technology Manufacturing Investment Tax Credit
    |         CA$ M
    |         120
    |                        Change in Working Capital
    |         CA$ M
    |         (15)
    |                        Pre-Tax Cash Flow
    |         CA$ M
    |         7,536
    |                        Income Tax, Federal
    |         CA$ M
    |         (1,049)
    |                        Income Tax, Provincial
    |         CA$ M
    |         (699)
    |                        Mining Tax, Provincial
    |         CA$ M
    |         (645)
    |                        After Tax Cash Flow
    |         CA$ M
    |         5,144
    |                        Cost Metrics (real terms)
    |                        C1 Cost2, 4
    |         CA$/tonne of concentrate sold
    |         602
    |                        All-In Sustaining Cost (AISC)3, 4
    |         CA$/tonne of concentrate sold
    |         624
    |                                                                    Notes:
   1.   The inflation rate is used in the tax, depreciation, and working  capital calculations only. The results of these calculations are  deflated using the same inflation rate for use in the cash flow model.
   2.   C1 Cost and C1 Cost per tonne of concentrate sold: C1 Cost consists of  all production related expenses including mining, processing, services,  tailings handling, royalties, and general and administrative, plus  treatment charges, penalties, transportation and other selling costs. C1  Cost per tonne of concentrate sold is calculated as C1 Cost divided by  tonnes of spodumene concentrate sold.
   3.   All-in Sustaining Costs (AISC) and AISC per tonne of concentrate sold:  AISC consists of C1 Cost plus sustaining capital. AISC per tonne of  concentrate sold is calculated as AISC divided by tonnes of spodumene  concentrate sold.
   4.   C1 Costs and AISC are non-GAAP financial measures or ratios and have no  standardised meaning under IFRS Accounting Standards and may not be  comparable to similar measures used by other issuers. As the Project is  not in production, Frontier does not have historical non-GAAP financial  measures nor historical comparable measures under IFRS, and therefore  the foregoing prospective non-GAAP financial measures or ratios may not  be reconciled to the nearest comparable measures under IFRS.
   5.  G&A Opex presented in this section includes allowances for operations insurance and community program payments.
   6.  Numbers may not add due to rounding.
    |                                 Mineral Resource and Reserves Estimate
  The PAK Project is a greenfield project located approximately 175 kilometers (km) north of the municipality of Red Lake, Ontario  within the Red Lake Mining Division and the traditional territory of  four First Nations (Figure 1). The Project spans nearly 28,000 hectares  and hosts Ontario's highest-grade and  largest lithium resource. Since 2013, Frontier has defined three  high-quality spodumene-bearing deposits—PAK, Spark, and Bolt—located  within just 3 km of each other. Ongoing exploration has also led to the  discovery of two additional spodumene-bearing pegmatites Ember and  Pennock, both situated within the broader Project area.
  The Mineral Resource Estimates for the Project were based on 10,008 metres (m) drilled in 54 drillholes plus 244 m of surface channels at PAK; 22,956 m in 77 drillholes plus 363 m of channels at Spark and 3,085 m in 15 drillholes plus 134 m  of channels at Bolt. The PAK Lithium Project's Proven and Probable  mineral reserve is 31.1 million tonnes (Mt) averaging 1.51% Li2O, which is included within the Measured and Indicated mineral resource of 35.2 Mt averaging 1.53% Li2O.  The mineral reserve and resource estimates for the PAK Lithium Project  are summarized in Tables 2 through 4 below, which detail the drill and  channel sampling data supporting the estimates, along with the breakdown  of Proven and Probable reserves and the Measured and Indicated  resources across the PAK, Spark, and Bolt deposits. Table 4 provides as  well as a comparison between the 2023 PFS and 2025 FS Mineral Reserves.
  Table 2: Summary of the Mineral Resource Estimate

  |         Deposit
    |         Category
    |         Li2O Cut Off Grade (%)
    |         Tonnage (kt)
    |         Li2O Grade (%)
    |         Contained Li2O (kt)
    |                        Open Pit
    |         PAK
    |         Measured
    |         0.65
    |         2,585
    |         2.03
    |         52
    |                        Indicated
    |         1,521
    |         1.96
    |         30
    |                        Measured + Indicated
    |         4,106
    |         2.00
    |         82
    |                        Inferred
    |         122
    |         1.50
    |         2
    |                        Spark
    |         Measured
    |         0.65
    |         13,796
    |         1.54
    |         212
    |                        Indicated
    |         17,304
    |         1.41
    |         244
    |                        Measured + Indicated
    |         31,100
    |         1.47
    |         456
    |                        Inferred
    |         10,954
    |         1.53
    |         167
    |                        Bolt
    |         Measured + Indicated
    |         0.65
    |         -
    |         -
    |         -
    |                        Inferred
    |         5,516
    |         1.23
    |         68
    |                        Total
    |         Measured
    |         0.65
    |         16,381
    |         1.61
    |         264
    |                        Indicated
    |         18,825
    |         1.45
    |         273
    |                        Measured + Indicated
    |         35,206
    |         1.53
    |         538
    |                        Inferred
    |         16,592
    |         1.43
    |         237
    |                        Underground
    |         PAK
    |         Measured
    |         0.80
    |         -
    |         -
    |         -
    |                        Indicated
    |         1,703
    |         2.39
    |         41
    |                        Measured + Indicated
    |         1,703
    |         2.39
    |         41
    |                        Inferred
    |         1,995
    |         2.19
    |         44
    |                                                                                        1.     The Mineral Resource Estimate has been estimated using the Canadian  Institute of Mining, Metallurgy and Petroleum (CIM) Definitions  Standards for Mineral Resource and Mineral Reserve in accordance with  National Instrument 43-101 - Standards of Disclosure for Mineral  Projects. Mineral Resources which are not Mineral Reserves, do not have  economic viability.
    |                        2.    Inferred Mineral Resources are exclusive of the Measured and Indicated Resources.
    |                        3.    In-pit Resources are constrained by Pseudoflow optimized pit shells using HxGn MinePlanTM 3D
    |                        4.    Pit shells were developed using pit slopes of 45 0 for PAK and Bolt and 43 degrees for Spark, sales price of U$1,500/t for 6.0% Li2O  chemical grade concentrate, exchange rate of 1.30 CA$/US$, mining costs  of US$7.80/t and US$7.15/t for ore and waste, respectively, processing  costs of US$23.85/t milled, G&A costs of US$26.22/t milled,  sustaining capital costs of US$4.28/t milled, closure costs of US$1.99/t  milled, process recovery of 78.0%,and  transportation costs of US$100.79/t concentrate..
    |                        5.    In-pit estimates are reported in-situ, at a cut-off grade of 0.65% Li2O.
    |                        6.    Underground mining stope optimization was performed using DeswikTM.
    |                        7.    Stope shapes were developed using a sales price of US$1,500/t for 6.0% Li2O  chemical grade concentrate, exchange rate of 1.30 CA$/US$, mining costs  of US$85.00/t, processing costs of US$23.85/t milled, G&A costs of  US$26.22/t milled, sustaining capital costs of US$4.28/t milled, closure  costs of US$1.99/t milled, process recovery of 78.0%, and transportation costs of US$100.79/t concentrate.
    |                        8.    Underground resources were estimated using a cut-off grade of 0.80% Li2O.
    |                        9.  Resource estimations were interpolated using Inverse Distance Weighting (IDW2); variable densities were also interpolated using the same method.
    |                        10.  The effective date of the Mineral Resource Estimate is November 30, 2023.
    |                        11.   The independent and Qualified Person for the Mineral Resource Estimate,  as defined by NI 43-101, is Schadrac Ibrango, P.Geo., of DRA Americas  Inc.
    |                        11.   Figures have been rounded to an appropriate level of precision for the  reporting of Mineral Resources. Thus, totals may not compute exactly as  shown.
    |                                        Notes:            Table 3: Summary of Mineral Reserve Estimate
                                     Open Pit
    |         Deposit
    |         Category
    |         Li2O Cut Off Grade (%)
    |         Diluted Tonnage (kt)
    |         Li2O Grade (%)
    |         Contained Li2O (kt)
    |                        PAK
    |         Proven
    |         0.65
    |         2,520
    |         1.97
    |         50
    |                        Probable
    |         1,427
    |         1.94
    |         28
    |                        Proven + Probable
    |         3,947
    |         1.96
    |         77
    |                        Spark
    |         Proven
    |         0.65
    |         13,670
    |         1.51
    |         206
    |                        Probable
    |         13,514
    |         1.37
    |         185
    |                        Proven + Probable
    |         27,183
    |         1.44
    |         392
    |                        Total
    |         Proven
    |         0.65
    |         16,190
    |         1.58
    |         256
    |                        Probable
    |         14,941
    |         1.42
    |         213
    |                        Proven + Probable
    |         31,131
    |         1.51
    |         469
    |                                                                                        Notes:
    |                        1.     The Mineral Reserve Estimate has been estimated using the Canadian  Institute of Mining, Metallurgy and Petroleum (CIM) Definitions  Standards for Mineral Resource and Mineral Reserve in accordance with  National Instrument 43-101 - Standards of Disclosure for Mineral  Projects.
    |                        2.   The mineral reserve was derived from a pit limit analysis and detailed  pit design using Measured and Indicated Resources at a cut-off grade of  0.65% Li2O.
    |                        3.     Pit optimization was performed using pit slopes of 45°  for PAK and  Bolt and 43°  degrees for Spark, sales price of U$1,500/t for 6.0% Li2O  chemical grade concentrate, exchange rate of 1.30 US/CAD, mining costs  of US$7.80/t and US$7.15/t for ore and waste, respectively, processing  costs of US$23.85/t milled, G&A costs of US$26.22/t milled,  sustaining capital costs of US$4.28/t milled, closure costs of US$1.99/t  milled, process recovery of 78.0%, transportation costs of US$100.79/t  concentrate, discount rate of 8%, and assumed production rate of 1.04  Mtpa.
    |                        4. For PAK, the pit shell selected for the ultimate pit design is RF 0.60, based on a selling price of US$900 for a 6.0% Li2O  chemical-grade concentrate. For SPARK, the selected pit shell for the  ultimate design is RF 0.45, corresponding to a selling price of US$675  for a 6.0% Li2O chemical concentrate.
    |                        5.  For the PAK and SPARK deposit, the mineral reserve estimate includes external dilution and mining loss.
    |                        6.  PAK mineral reserves are based on a pit design with a 5.9 stripping  ratio. SPARK mineral reserves are based on a pit design with a 3.3  stripping ratio.
    |                        7.  The effective date of the Mineral Reserve Estimate is May 28, 2025.
    |                        8.   The independent and Qualified Person for the Mineral Reserve Estimate,  as defined by NI 43-101, is Ghislain Prevost, P.Eng., of DRA Americas  Inc.
    |                        9.   Figures have been rounded to an appropriate level of precision for the  reporting of Mineral Reserves. As a result, totals may not compute  exactly as shown.
    |                                                     Table 4: Comparison of 2023 and 2025 Mineral Reserve Estimates
                                     2025 - DFS Reserve
    |         2023 - PFS Reserve
    |         Increase kts Li2O (PFS-DFS)
    |                        Cut-off Li2O%
    |         Resource Category
    |         Tonnage (kt)
    |         Li2O %
    |         kts Li2O
    |         Cut-off Li2O%
    |         Resource Category
    |         Tonnage (kt)
    |         Li2O %
    |         kts Li2O
    |                        PAK - Open Pit
    |         PAK - Open Pit
    |                        0.65
    |         Proven
    |         2,520
    |         1.97
    |         50
    |         0.65
    |         Proven
    |         -
    |         -
    |         -
    |
  |                        Probable
    |         1,427
    |         1.94
    |         28
    |         Probable
    |         4,041
    |         1.79
    |         72
    |         -62 %
    |                        Proven-Probable
    |         3,947
    |         1.96
    |         77
    |         Proven-Probable
    |         4,041
    |         1.79
    |         72
    |         7 %
    |                        Spark - Open Pit
    |         Spark - Open Pit
    |
  |                        0.65
    |         Proven
    |         13,670
    |         1.51
    |         206
    |         0.65
    |         Proven
    |         -
    |         -
    |         -
    |
  |                        Probable
    |         13,514
    |         1.37
    |         185
    |         Probable
    |         18,028
    |         1.50
    |         270
    |         -32 %
    |                        Proven-Probable
    |         27,183
    |         1.44
    |         392
    |         Proven-Probable
    |         18,028
    |         1.50
    |         270
    |         45 %
    |                        PAK Lithium Project
    |         PAK Lithium Project
    |
  |                        0.65
    |         Proven
    |         16,190
    |         1.58
    |         256
    |         0.65
    |         Proven
    |         -
    |         -
    |         -
    |
  |                        Probable
    |         14,941
    |         1.42
    |         212
    |         Probable
    |         22,069
    |         1.55
    |         343
    |         -38 %
    |                        Proven-Probable
    |         31,131
    |         1.51
    |         469
    |         Proven-Probable
    |         22,069
    |         1.55
    |         343
    |         37 %
    |                                                     Project Economics
  The PAK Project's mine and mill  is designed to produce 200,000 tonnes of chemical-grade concentrate  annually, totaling approximately 6.1 million tonnes over a 31-year mine  life. The Project is expected to generate a total of $5.14 billion in after-tax cash flow, driven by strong operating margins and capital requirements.
  With projected net revenue of $11.3 billion, the financial plan includes $943 million in initial development capital, $137 million in sustaining capital, and $60 million in closure costs. This capital structure supports robust cash generation with average annual earnings of $285 million. These figures underscore the Project's potential to deliver strong and sustained economic returns.
  The long-term spodumene concentrate price assumption of US$1,475 per tonne, on a FOB basis at Thunder Bay,  supports the Project's economic modeling. This assumption is informed  by a pricing study incorporating forecasts from SC Insights, a battery  supply chain consultant, and several financial institutions. While the  lithium market remains in an early stage of development, structural  demand growth, primarily driven by the electric vehicle sector, combined  with forecasted regional supply deficits, supports a sustained positive  price environment. These fundamentals support a strong long-term  outlook for spodumene concentrate pricing.
  The base case for the PAK Project delivers an after-tax NPV8% of $932 million,  an IRR of 17.9%, and a 4.0-year payback period reflecting strong  fundamentals. Sensitivity analysis shows Project value is most  responsive to spodumene concentrate prices.  For example, a 20% increase  in spodumene concentrate prices raises NPV of the Project to $1.37 billion and IRR to 21.6%, while a 10% decrease in spodumene concentrate prices reduces the NPV of the Project to $712 million and the IRR to15.9%. The economic analysis is based on an assumed FID in first half 2027 and project kick off in June 2026.
  Operating and capital costs for the Project have a more moderate sensitivity impact. A 20% decrease in total Opex lifts NPV to $1.03 billion (IRR 18.9%), while a 20% increase reduces it to $830 million (IRR 17.0%). Capex shifts of ±20% move NPV between $1.04 billion and $824 million, with IRR ranging from 21.0% to 15.7%.
  Overall,  the PAK Project remains resilient under varied scenarios. Figure 2  below, demonstrates the Project's ability to maintain robust economics  across a range of key variables including capital and operating costs,  exchange rates, and concentrate pricing.
  Project Schedule
  The  overall schedule for the Mine and Mill segment of the PAK Lithium  Project has been developed during the DFS. Frontier anticipates to  secure key permits by the first half of 2027, which would enable the  FID. In parallel, a critical infrastructure initiative, the Beren's River Bridge  and all-season road, is expected to commence in 2025 and be completed  by the end of 2027 to more readily access the Project. An indicative  timeline of the major Project segments is presented in Figure 3 below.
  Prior  to advancing the Project to detailed engineering, the Project schedule  will be revisited and is subject to final design engineering, permitting  approvals, infrastructure upgrades, market conditions and project  financing activities. In addition, Frontiers intends to actively pursue  opportunities to optimize capital and operating costs, as well as  potential resource expansion, for integration to enhance overall Project  efficiency.
  Project Advancement & Opportunity Optimization
  Frontier  remains committed to advancing the mine and mill towards production,  while identifying opportunities to optimize the broader integrated  development. Key ongoing activities supporting this goal include:

 - Progressing through the permitting process while actively engaging  and consulting with First Nations and with governmental agencies. The  next major permitting milestones are Environmental Compliance Approval -  Air Emissions and Noise; Industrial Sewage and the Closure Plan.
 - Advancing development of all-season road access and infrastructure  in the region through engagement and consultation with First Nations and  with federal and provincial support.
  These actions are consistent with Frontier's goal of advancing  the fully integrated PAK Lithium Project, starting with the mine and  mill near Red Lake and becoming a leading lithium producer in North America.  Advancing the upstream segments and securing concentrate production are  essential steps toward enabling local conversion and capturing  investment in Ontario's emerging battery and electric vehicle supply chain.
  Report Filing
  The complete NI 43-101 technical report associated with the DFS will be available on SEDAR+ at  www.sedarplus.ca under the Company's issuer profile, as well as the Company's website at  www.frontierlithium.com within 45 calendar days of this press release.
  Qualified Persons
  All  scientific and technical information in this release has been reviewed  and approved by QP Schadrac Ibrango, P.Geo., of DRA Americas Inc., QP  Ghislain Prévost, P.Eng. of DRA Americas Inc., and QP Garth Drever,  P.Geo., VP Exploration for Frontier Lithium Inc. under the definitions  established by National Instrument 43-101.  Under Frontier's QA/QC  procedures, all drilling was completed by Chenier Drilling Ltd. of Val Caron, Ontario  using BTW and NQ drill rods and a Reflex ACT III oriented core system.  Using the Reflex system, the drill core was oriented and marked as it  was retrieved at the drill.  Either a Reflex EZ-Trac survey or a Reflex  Gyro Sprint-IQ instrument was used every 50 m  downhole and again at the end of each hole when rods were pulled out.  A  Reflex North Finder APS unit was utilized to complete accurate  positioning and orientation of the drill collar upon setup. The core was  boxed and delivered to the Frontier core shack where it was examined,  geologically logged, and marked for sampling. The core was photographed  prior to sampling.  Using a rock saw, the marked sample intervals were  halved with one-half bagged for analysis. Sample blanks along with  lithium certified reference material was routinely inserted into the  sample stream in accordance with industry recommended practices. Field  duplicate samples were also taken in accordance with industry  recommended practices. The samples were placed in poly sample bags and  transported to AGAT Laboratories Ltd. (AGAT) in Thunder Bay, Ontario for sample preparation and to Mississauga, Ontario  for processing and quantitative multi-element analysis. AGAT is an ISO  accredited laboratory. The core is stored on site at the Company's Knox  exploration camp.
  About Frontier Lithium
  Frontier  Lithium is a pre-production company committed to enabling  electrification by delivering sustainably sourced lithium products,  responsibly mined and processed in northern Ontario, to support North America's  electric vehicle and battery industries. The Company's PAK Lithium  Project holds the largest land position and proven lithium resource in Ontario's premier lithium district, located in the Great Lakes region.
  About the PAK Lithium Project
  The  PAK Lithium Project is a fully integrated lithium development  initiative advancing the highest-grade known lithium resource in North America.  Operated as a joint venture between Frontier Lithium Inc. (92.5%) and  Mitsubishi Corporation (7.5%), the project includes two key segments:  Mine and Mill, and Downstream Conversion Facility for battery-grade  lithium salt production. A 2025 Feasibility Study (FS), prepared by DRA  and entitled National Instrument 43-101 Technical Report FS PAK Lithium Project, Mine and Mill, outlines a 31-year Project life with an after-tax NPV of CA $932 million at an 8% discount rate and an after-tax IRR of 17.9%. These results were disclosed in a press release dated May 28, 2025, and will be filed on SEDAR+ ( www.sedarplus.ca). The full technical report will be filed within 45 days of the press release.
  Cautionary Note Regarding Forward-Looking Statements
  This  news release includes certain statements that may be deemed  "forward-looking statements". All statements in this release, other than  statements of historical fact constitute forward-looking statements.  Forward looking statements contained in this news release may include,  but are not limited to, statements with respect to: estimated mineral  resources, estimated capital costs and timing to construct mine  facilities, estimated operating costs (including sustaining costs and  improvements in respect thereof), all estimates and assumptions relating  to the economic analysis and financial summaries, the duration of  payback periods, expected strip ratios, estimated amounts of future  production, estimated accumulated revenues, estimated cash flows,  lithium prices and assumptions, net present value, internal rate of  return, the DFS, technical report, the pre-feasibility study and its  assumptions, and statements that address future production, resource and  reserve potential, exploration drilling, exploitation activities and  events or developments that the Company expects.
  Although the  Company believes the expectations expressed in such forward-looking  statements are based on reasonable assumptions, such statements are not  guarantees of future performance and actual results may differ  materially from those expressed in the forward-looking statements.
  Forward-looking  statements involve inherent risks and uncertainties. Risk factors that  could cause actual results to differ materially from those in forward  looking statements include: the Company may not develop its mineral  projects into a commercial mining operations, lithium prices and  assumptions as the lithium market continues to evolve to a more  centralized market and away from a concentrated market in China  and as such the lithium market and its pricing does not yet possess the  price certainty features that other tradeable metals with a more mature  market have, making price assumptions and forecasting for lithium  complex and uncertain, accuracy of mineral reserve and resource estimate  and related assumptions, increases in capital or operating costs,  construction timing, costs and risks of completion, availability of  infrastructure including roads, regulatory and permitting risks,  exploitation and exploration successes, continued availability of  capital and financing (both private and public), financing costs, and  general economic, market or business conditions. Investors are cautioned  that any such statements are not guarantees of future performance and  those actual results or developments may differ materially from those  projected in the forward-looking statements. For more information on the  Company, please review the Company's public filings available at  www.sedarplus.ca.
  Neither  the TSX Venture Exchange nor its Regulation Services Provider (as that  term is defined in the policies of the TSX Venture Exchange) accept  responsibility for the adequacy or accuracy of this release.
  SOURCE Frontier Lithium Inc.

  Company  Contact Information: Bora Ugurgel, Senior Manager, Investor Relations,  2614 Belisle Drive, Val Caron, Greater Sudbury, ON., P3N 1B3 CANADA, T.  +001 705.897.7622, F. +001 705.897.7618
              		                               |
